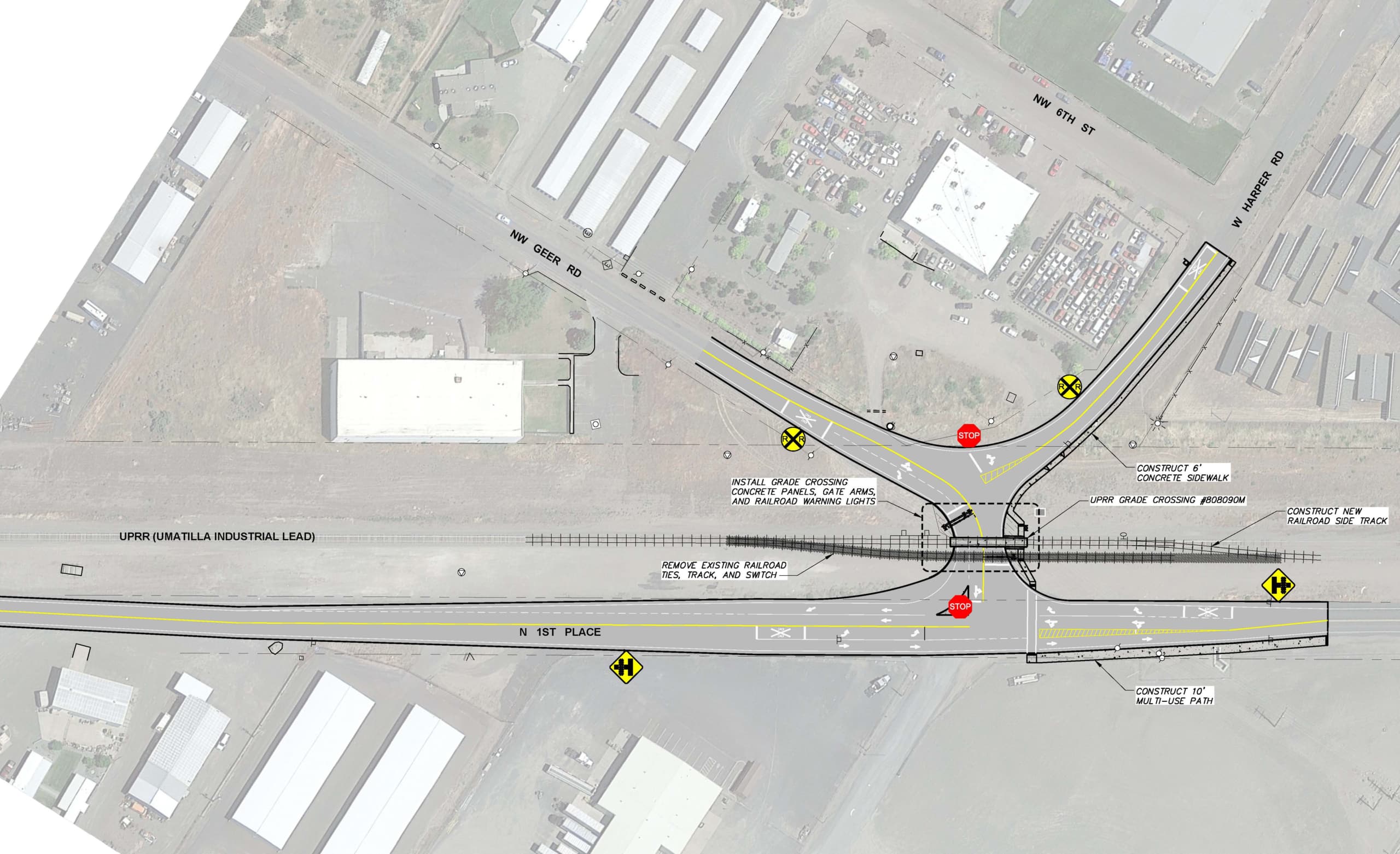

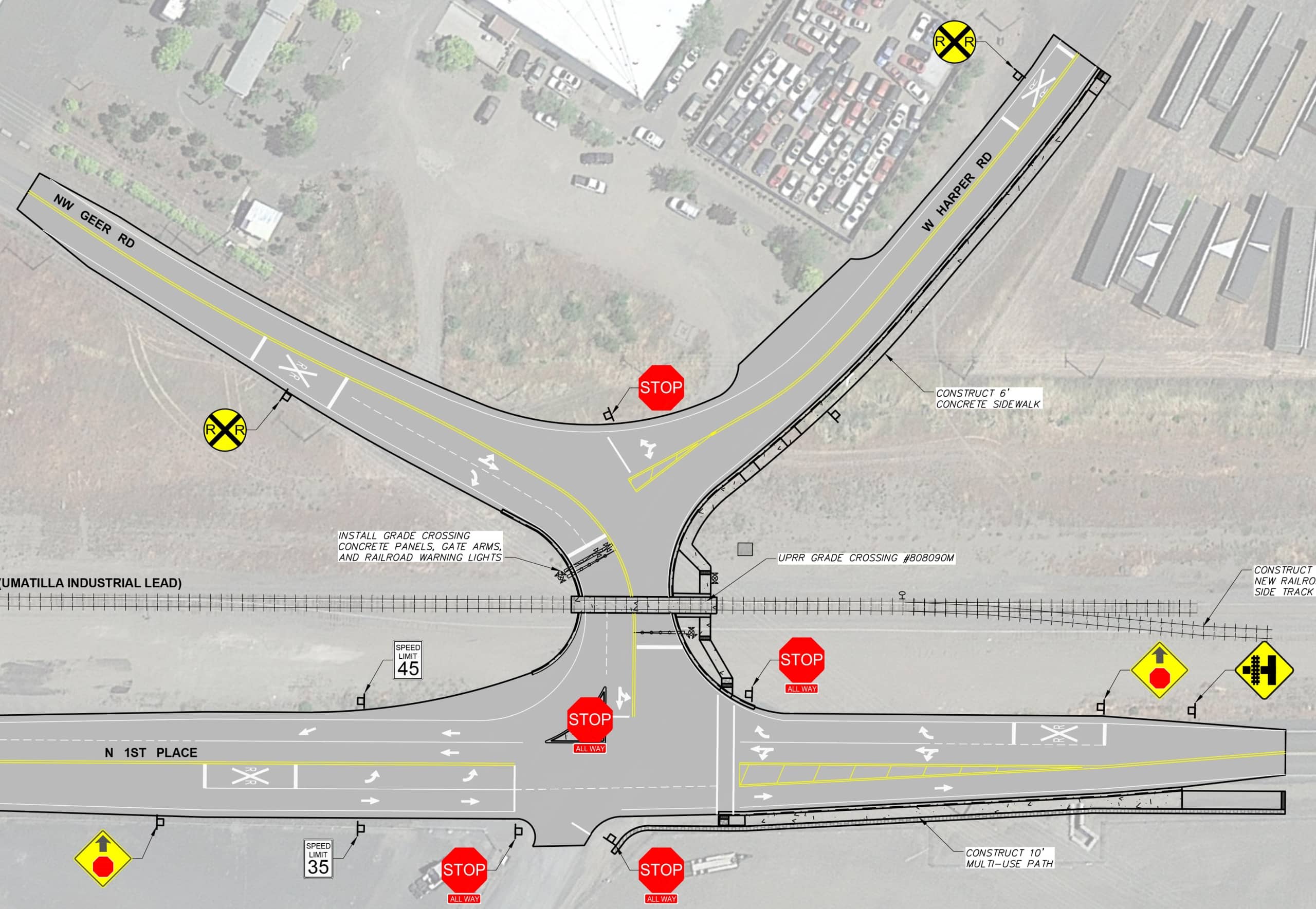

Geer/Harper/1st Realignment

The intersecion of N.W. Geer Road, W. Harper Ave. and N. 1st Place.

DESCRIPTION

PROJECT ID: ST 4.0
ESTIMATED COST: $1,560,000
ACTUAL COST: TBD
  • Will redevelop the three-way intersection that also includes Union Pacific railway.
  • Road work will include resurfacing for a smoother surface, restored drainage, and matching sidewalk elevations, with work coordinated with Union Pacific and other utilities.
  • Stripes, crosswalks and manholes will also be adjusted.

WHY IT’S NEEDED

The intersection needs to be reconstructed to improve traffic and pedestrian access, and ensure connectivity to property east of N. 1st Place. The current configuration makes access difficult for large trucks, and traffic backs up on Harper Road during busy times of day.

Repair work will also eliminate extensive patching and depressed areas from traffic and development. Sidewalks will be added.

PROJECT STATUS:
In Progress
PROJECT MILESTONES

2019

Intersection realignment first included in adopted Capital Improvement Plan.

2020

Union Pacific Railroad requires realignment to move Northwest to reduce track crossings.

2021

Right of way acquisition begins.

2022

Cost-benefit of right of way acquisition shifts focus back to original alignment.

2023

Union Pacific Railroad begins review of proposed realignment at existing crossing.

2024

Union Pacific Railroad provides preliminary feedback & requirements.

Summer 2025

Union Pacific Railroad accepts proposed alignment.

Fall 2025

Design engineering begins; targeting 2026 construction

“Hermiston sets sights on redesign of Harper Road-Geer Road intersection” – Northeast Oregon Now, 1/28/20 (link)

“Confusing intersection added to Hermiston transportation priority list” – East Oregonian, 6/11/14 (link)

Scheduled for
2025-26

LAST UPDATED: 09/24/25
